Do you want to better control your projects, keep project costs in check, and avoid schedule overruns? Then Earned Value Analysis (EVA) is exactly what you need. You may also encounter this project management method under the names “performance value method” and “Earned Value Management.” This tool requires a small amount of additional effort in project management, but it is brilliant. Let’s take a look at how you can use EVA to once again distinguish yourself as a successful project manager.
First, a brief look back: Earned Value Analysis has its roots in the American defense sector of the 1960s. It was introduced to enable better control of large and complex projects. The government wanted to ensure that schedules were met and taxpayer money was used efficiently. The goal was to create a standardized method for project controlling that measures progress and makes both schedule and cost variances visible. This concept quickly became a model for other industries that also work with large project budgets and tight time constraints.
What is Earned Value Analysis?

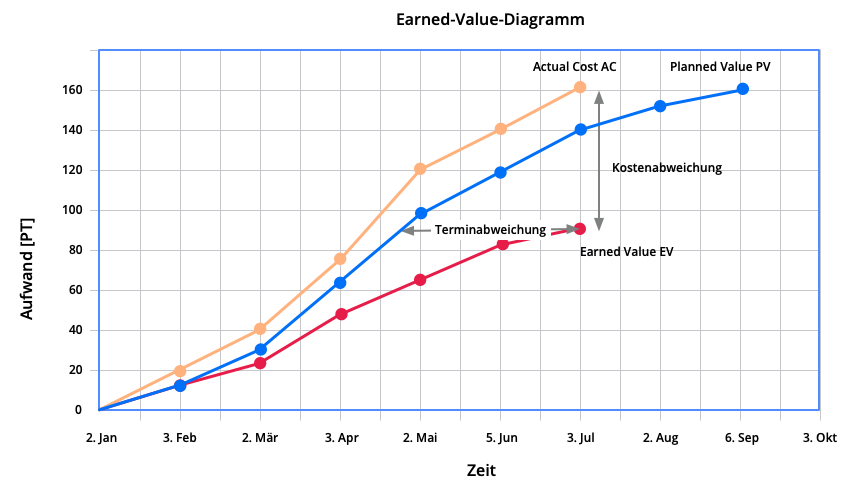

Earned Value Analysis is no rocket science — even though it is frequently used in technical projects. At its core, it is about measuring a project’s progress by relating costs, time, and performance to one another. It combines planned work, work completed, and resources spent in a single method.
Imagine you are building a house. You plan to lay the foundation in the first week, for which you have budgeted €5,000. After one week you find that the foundation is done, but it cost €6,000. Where do you stand? And how much will the complete house likely cost? Those extra €1,000 probably won’t be the end of the overruns, right? That is exactly where EVA comes in — it helps you evaluate situations like this.
The method is not only theoretically sound but has proven itself in countless projects. In a sense, it makes the parameters of the project management triangle quantifiable and visible. It works for small and large projects alike and provides concrete answers to the question of where things stand with regard to time and cost. The key is simply this: you need to understand the fundamentals before you can successfully apply EVA.
Why is Earned Value Analysis important?
Projects are in some ways like sailboats: without clear steering and constant monitoring of influencing factors, they quickly lose direction. EVA provides exactly that steering.
Greater Transparency
With EVA, you know at any time where your project stands. You can see not only how much you have spent, but also whether those expenditures are proportionate to the work delivered. No guessing, no gut decisions.
This transparency has another benefit: you can provide your stakeholders with well-founded reports. If someone asks why the project is costing more than expected, you have the answers ready. That builds trust and reduces conflicts — and it works in every form of project organization.
Early Warning Signals
One of my biggest lessons as a project manager? Recognizing problems early is the key. With EVA, you can quickly identify variances and course-correct before your project goes off the rails.
A practical example: in a project to develop a new machine model, elevated material costs became apparent after just a few weeks. Thanks to EVA, we were able to quickly identify and fix the planning error. Without this method, we would have reacted much later — probably too late.
Objective Basis for Decisions
Many decisions in project management are based on assumptions. EVA reduces this risk. By clearly presenting actual figures and variances, you can make well-informed decisions. This is especially important when it comes to budget increases or schedule extensions.
How does Earned Value Analysis work?
EVA is based on three central values. Don’t worry — it’s simpler than it sounds.
Planned Value (PV)
The Planned Value is the value of the work you planned to have completed by a given point in time. Example: returning to your house construction, you wanted to have 50% of the foundation finished after two weeks. That corresponds to a Planned Value of €2,500.
A planned value gives you a baseline against which to assess your progress. It is important to record the PV in your project plan. You should only change it if the underlying conditions under which you created the original plan have changed.
Earned Value (EV)
The Earned Value indicates how much work you have actually completed — measured in work hours or financial terms. If after two weeks 40% of the foundation is complete, the Earned Value is €2,000.
The Earned Value is the pivot point of the analysis. It gives you a clear picture of whether you have achieved the planned level of performance or not.
Actual Cost (AC)
The Actual Cost is the cost actually incurred. If you have spent €3,000 up to this point, that is your AC.
The special thing about AC is that it is directly measurable. There is no room for interpretation — only clear numbers.
The Magic of the Combination
When you compare these three values with one another, you get a comprehensive picture of your project. Are you ahead of or behind plan? And are your expenditures justified? That is exactly what you need to know to steer your project safely.

A Detailed Example for Illustration
Let’s say you are managing a software development project. Your goal is to develop a new app in three months. The total budget is €150,000. After one month you have spent €50,000. According to your plan, you should have completed 40% of the project by this point (Planned Value = €60,000). Your developers report, however, that only 30% of the work is done (Earned Value = €45,000).
- Cost Variance (CV): EV - AC = 45,000 - 50,000 = -€5,000. The project is more expensive than planned.
- Schedule Variance (SV): EV - PV = 45,000 - 60,000 = -€15,000. The project is behind schedule.
- Cost Performance Index (CPI): EV / AC = 45,000 / 50,000 = 0.9. For every euro spent, you are getting only 90 cents of value.
- Schedule Performance Index (SPI): EV / PV = 45,000 / 60,000 = 0.75. You have completed 75% of the planned work.
These numbers show you clearly that the project is lagging both in time and financially. With this information you can take targeted action — for example, redistribute resources, adjust the schedule, or review the cost structure. This example illustrates how EVA helps you make well-informed decisions and get your project back on track.
Which key metrics are critical?
Here comes the interesting part. With EVA’s key metrics, you transform raw data into actionable insights.
Cost Variance (CV) and Schedule Variance (SV)
- Cost Variance (CV): EV - AC. Surprisingly high costs? A negative CV tells you that you are over budget.
- Schedule Variance (SV): EV - PV. Delays? A negative SV means you are behind schedule.
Cost Performance Index (CPI) and Schedule Performance Index (SPI)
- CPI: EV / AC. A value below 1 indicates that your project is more expensive than planned.
- SPI: EV / PV. A value below 1 means that your project is behind schedule.
Forecasting and Control
EVA’s key metrics are not only helpful for understanding the current status. They are also a valuable tool for creating forecasts. If your CPI consistently sits at 0.9, you know that you will likely end up 10% over budget. With this information, you can take corrective action early.
How is EVA used in practice?
The theory is interesting, but how do you actually implement EVA? Here is a step-by-step guide:
1. Project Planning
Without a solid plan, EVA is useless. Define clear work packages, schedules, and budgets. Every task should be measurable. Project planning is the foundation of EVA. Without clear goals, you cannot measure variances.
2. Regular Data Collection
Capture the progress of your tasks, the costs incurred, and the milestones reached. Without up-to-date data, EVA is like a compass without a needle. Make sure your teams are trained and know how to provide the necessary data.
3. Analysis and Action
Use the key metrics to identify problems. Is your CPI below 1? Then look for ways to cut costs. Is your SPI critical? Find out why the schedule is not being met. Analysis is an ongoing process. You need to be flexible enough to respond to changes.
4. Communication
EVA is only as effective as the way you communicate its results. Make sure all stakeholders understand the reports and know what consequences the results have. In a matrix organization, don’t forget to keep leadership informed.
Which tools support EVA?
A good captain needs the right instruments. The same applies to project managers. Here are some of the best tools for EVA:
- MS Project: Perfect for comprehensive project plans.
- Primavera P6: A favorite for large technical projects.
- Allegra: Hidden champion for pragmatic project management.
- Excel: Often sufficient for smaller projects — provided you master the formulas.
Tip:
Try out different tools and find out which one best fits your style and your project. Remember that the tool is only as good as the person using it.
Which mistakes should be avoided?
EVA is only as good as the data you put into it. Here are some typical mistakes and how to avoid them:
- Unclear goal definitions: Without clear goals, you don’t know what success looks like.
- Faulty data collection: Inaccurate or delayed data renders EVA worthless.
- Ignoring results: The best analyses are useless if you don’t act on them.
Once I forgot to train a team member on how to correctly report progress data. The result? Incorrect CV and SPI values that cost us nearly a month to correct.
Continuous Improvement
EVA is a learning process. Use the experience from every project to improve your methods. Mistakes are inevitable, but they also offer the best lessons.
Comparison with Burn-Down Charts and Milestone Trend Analysis
Earned Value Analysis (EVA) is an effective tool, but how does it compare to other widely used methods such as burn-down charts and milestone trend analysis? Let’s take a closer look.
Burn-Down Charts
Burn-down charts are especially popular in agile projects. They visualize how much work remains and help track progress against planned time. The advantage: they are easy to create and easy to interpret. However, they often lack the depth that EVA provides. A burn-down chart doesn’t tell you whether you are exceeding your budget or whether your costs are proportionate to performance. In a complex project, such information can be critical.
Milestone Trend Analysis
Milestone trend analysis focuses on the adherence to milestones and their schedule trends. It is ideal for identifying schedule delays and is especially helpful in projects with clearly defined stages. What it lacks, however, is the integration of cost data. EVA goes one step further by linking cost and schedule variances, delivering a more comprehensive picture.
Summary
While burn-down charts and milestone trend analysis are simple and specific tools, EVA offers a deeper analysis that combines cost, time, and performance. The choice of the right project management tool ultimately depends on the requirements of your project. In many cases, combining methods can deliver the greatest benefit.
How do you convince stakeholders of EVA?
Not everyone loves numbers and analysis. EVA requires the collection and monitoring of a few additional data points that your project team members need to enter. They may not always see the benefit for themselves. Here are a few tips to win stakeholders over:
- Explain the benefit: Show how EVA reduces costs and mitigates risks.
- Visualize the data: A simple chart often says more than a thousand words.
- Deliver results: Use examples to show how EVA has improved your project.
Earned Value Analysis at a Glance
Earned Value Analysis is not a cure-all, but it is an indispensable tool for project managers who want to secure the success of their projects. With clear numbers, constant monitoring, and timely action, you stay on course — no matter how turbulent the project becomes.
Take the time to integrate EVA into your projects. Your projects — and your team — will thank you for it. And don’t forget: every step toward improvement makes you an even better project manager.
Frequently Asked Questions
What is Earned Value Management?
Earned Value Analysis (EVA) is a method that measures a project’s progress by combining costs, time, and performance. It helps identify variances and steer projects more effectively.
What are the benefits of Earned Value Analysis?
EVA provides transparency over a project’s time and costs, identifies variances early, and enables well-informed decisions. It reduces risks and optimizes project controlling.
How is Earned Value Analysis performed?
EVA is based on three central values: Planned Value (PV), Earned Value (EV), and Actual Cost (AC). By comparing these values, key metrics such as Cost Variance (CV) and Schedule Variance (SV) are derived, which assess the project’s progress and efficiency.
When should Earned Value Analysis be used?
EVA is suitable for projects with clearly defined goals, budgets, and schedules. It is frequently used in large, complex projects, but is also helpful for smaller endeavors.
Which tools support Earned Value Analysis?
The most popular tools include MS Project, Primavera P6, and Excel. These tools support the capture and analysis of project metrics to apply EVA efficiently.
